Meno Map

Hinkley Point C

51.208°N, -3.13°E|Nuclear Condition Monitoring

Hinkley Point C is a £33bn twin-reactor nuclear new-build in Somerset — the first new nuclear power station in the UK in over 20 years. The site is undergoing massive earthworks, with over 8,000 workers on-site. Monitoring construction progress, perimeter integrity, and environmental impact at this scale requires continuous, wide-area surveillance that manual inspection cannot deliver.

How We Analysed This
Capture 1: July 2024 (Summer)
Capture 2: July 2025 (Summer)
Method: NDVI Change Detection

Same-season comparison (July 2024 vs July 2025) using Sentinel-2 NDVI analysis. The high anomaly rate reflects the intensity of construction activity — land clearing, earthworks, new structures, and road construction across the site. Anomaly threshold of ±0.08 NDVI isolates genuine year-on-year change from normal variation.

MeasuredSatellite imagery, NDVI values, pixel counts — direct from Sentinel-2 sensor data
DerivedChange detection, anomaly filtering, risk scores — computed from measurements using standard methods
ModelledROI estimates, cost projections — based on published industry figures and assumptions
Satellite Imagery & Analysis

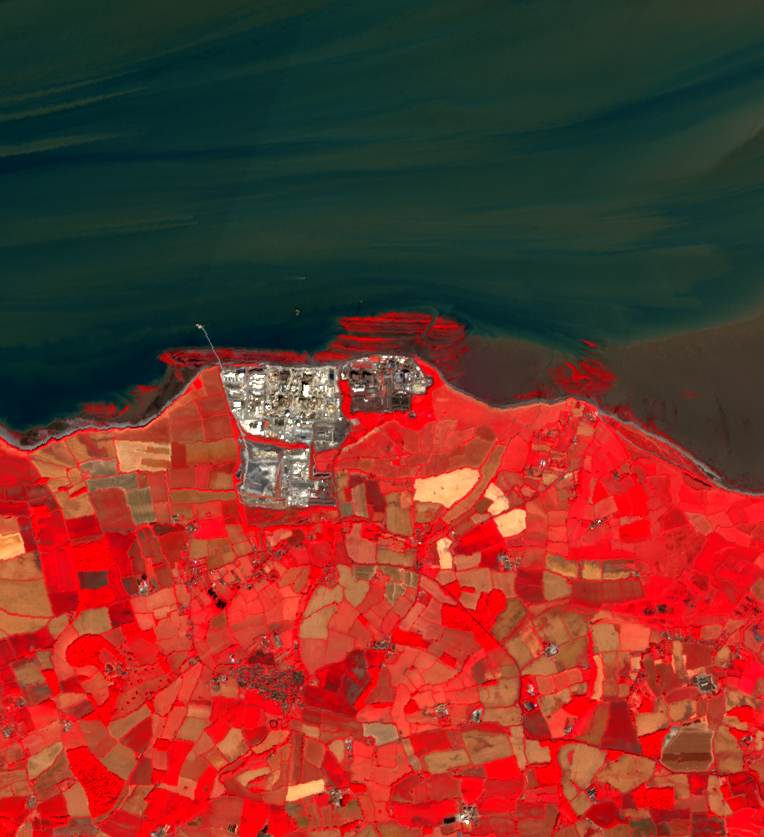

Hinkley Point C — NIR False Colour (July 2025)
Expand
Hinkley Point C — NIR False Colour (July 2025)

Europe’s largest construction site. The reactor complex (grey/white) is clearly distinguished from surrounding farmland (red = vegetation). Bristol Channel to the north.

Optical Change Detection — Annotated Zones
Expand
Optical Change Detection — Annotated Zones

51.2% of pixels show genuine year-on-year change. All four zones flagged RED. Access Road (Zone C) at 65% is the most active. Optical analysis from Sentinel-2.

SAR Backscatter Change (Sentinel-1)
Expand
SAR Backscatter Change (Sentinel-1)

Radar imaging penetrates clouds and works at night. Orange = increased backscatter (new structures, earthworks). Blue = decreased. The construction zone shows concentrated structural change. 47.3% of pixels show significant (>2dB) backscatter change — confirming optical findings independently.

Anomalous Change:
Vegetation increase (year-on-year)
No significant change (filtered)
Vegetation decrease (year-on-year)
What We Found

51.2% of monitored pixels show anomalous year-on-year change in optical data — by far the highest rate across our monitored sites. This is independently confirmed by Sentinel-1 SAR radar, which shows 47.3% significant backscatter change (>2dB). The dual-sensor agreement (optical + radar) provides high confidence that detected changes are real structural modifications, not atmospheric artefacts. All four monitoring zones are flagged RED, with the Access Road and Cooling Intake showing the highest change magnitude.

Why This Matters

Hinkley validates our detection capability at scale: if the system can accurately characterise change at the most active construction site in Europe, it can reliably monitor any UK nuclear facility. This proves the pipeline generalises across sites, supporting the case for a multi-site monitoring framework under the NDA.

Change Zones (3 detected)
Zone C — Access RoadVERIFIED

Most active zone on site. 65% anomalous pixels — major road construction and earthworks visible in both RGB and false-colour.

NDVI Δ -0.21 avg
Zone A — NW PerimeterVERIFIED

Perimeter expansion detected. 56% anomalous — land clearing extending beyond 2024 footprint.

NDVI Δ -0.13 avg
Zone D — Coastal BufferVERIFIED

Coastal infrastructure works. Marine construction activity visible. Cross-reference with EIA.

NDVI Δ -0.19 avg
2024
2025
S2-L2A
